Construction Update – Project 1-26 Concrete Street Paving

Andrea Fencl
June 01, 2026

Check out the presentation from the Public Information Meeting that was held April 29 on our Engineering Projects page.

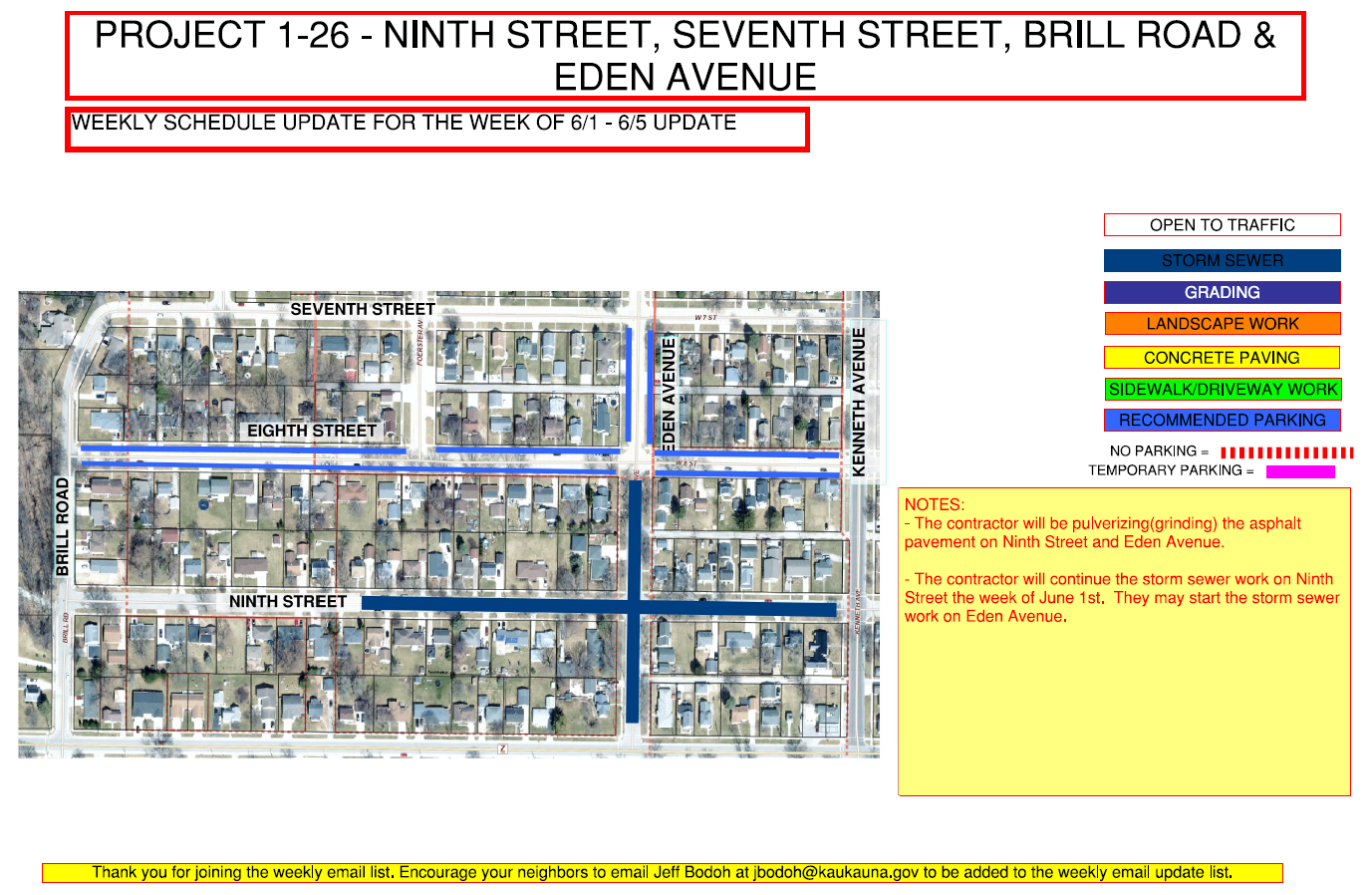

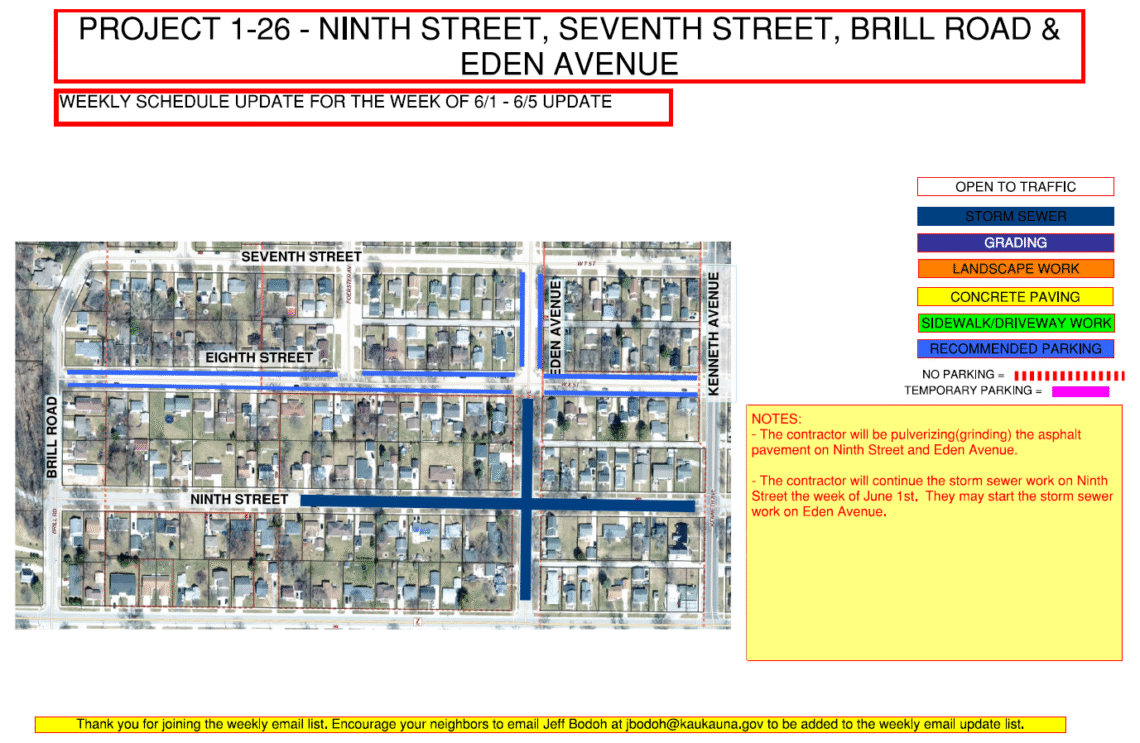

Week of June 1

  • VCC Grading-Complete grading on Florence (M-T)

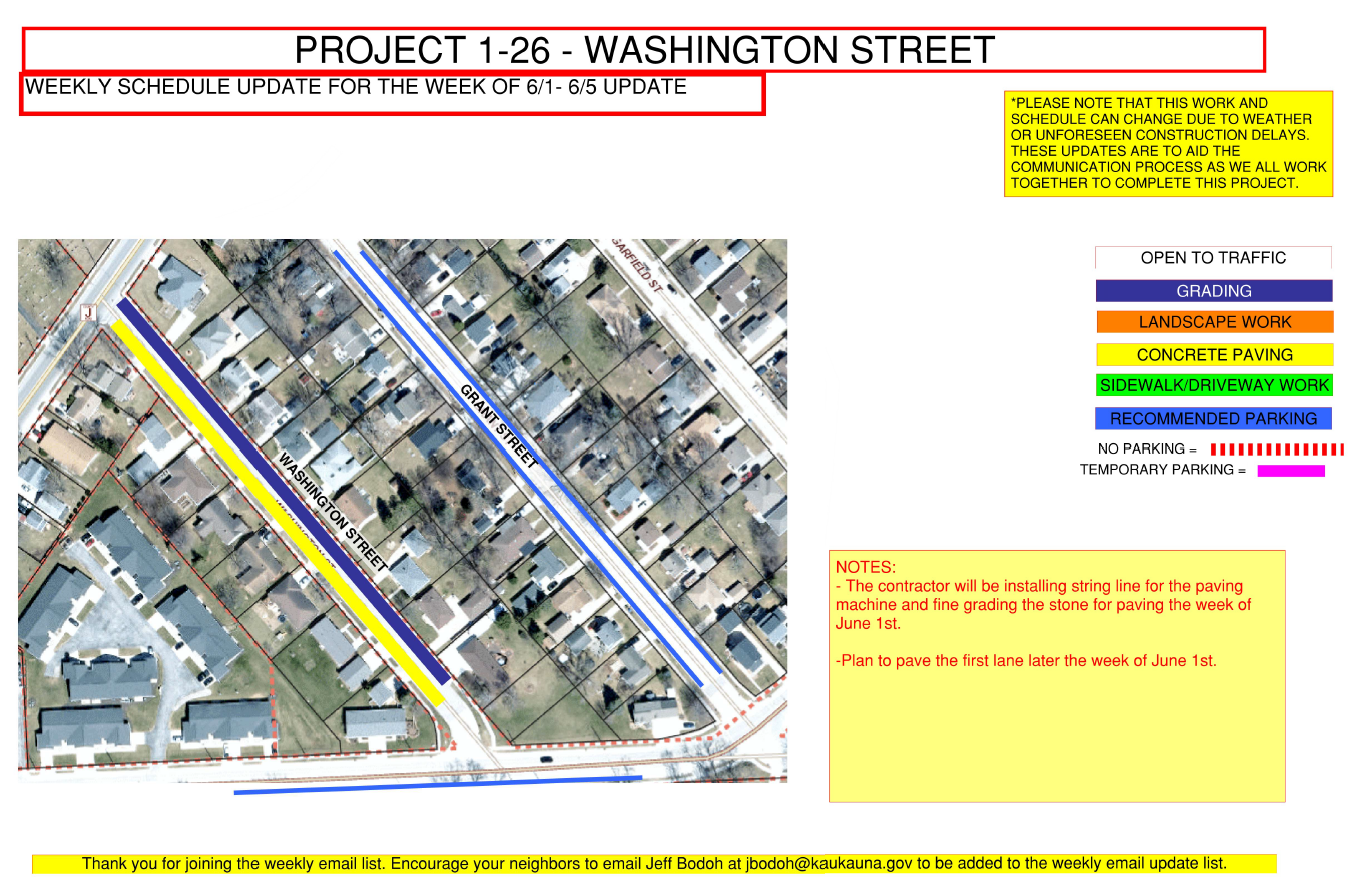

  • TNT-Concrete Street Paving – staking on Washington & Florence (W)
  • VCC Concrete-line/Trim 1st sides (W-TH)
    • Pave 1st sides on Friday
  • VCC Sewer–Continue work on 9th Street Complex (M-F)

Week of June 8

  • TNT-Stake out second sides of Wash/Florence (M)
  • VCC Concrete-Set line and trim on 2nd sides (W-TH)
    • Pave 2nd Sides (F)
  • VCC Sewer-Continue 9th street complex (M-F)

Week of June 15

  • VCC Sewer-Continue storm on 9th Street Complex (M-F)
  • VCC Concrete-Handwork/tie-inns on Washington & Florence (M-T)
  • VCC Grading-Prep concrete approaches (W-TH)
  • Martell-Driveway approaches Washington/Florence (F)

Week of June 22

  • VCC Sewer-Continue 9th street complex (M-F)
    • **Complete underground on the complex July 3rd**
  • Martell-Complete Driveway approaches (Washington & Florence) (M-T)
  • VCC Concrete-Form and pour 2nd side tie-inns (Washington & Florence) (M-T)
  • Highway-Begin Backfill and restoration(Washington & Florence) (F)

General Notes

DRIVEWAYS/PARKING – Please do not park on the road while the contractor is performing their work in the area. They need plenty of room for their trucks and equipment to be able to easily, quickly, and safely complete their work. Park in your driveway if possible, or on the nearest side street.

  • If you need special accommodations for parking, please reach out to Jeff Bodoh as we can arrange different parking options. This includes anyone with disabilities, recent surgeries, expecting mothers, and mothers with newborns that have appointments. Unfortunately, there is no “one size fits all” for parking and property access. The fewer cars that the contractor has to work around, the faster they can get the work done on your block and move on.

WORK ZONE SAFETY – While driving through the construction site, be sure to travel slowly and keep an eye out for equipment. This not only cuts down on dust, but also keeps the construction workers safe. Operators try their best to see traffic, but their view can be obstructed at times. It is always best to try and gain eye contact with equipment operators prior to driving by. You may need to wait at times before driving by depending on the work being performed. Please be patient during construction.

*  PLEASE NOTE THAT THIS WORK AND SCHEDULE CAN CHANGE DUE TO WEATHER OR UNFORSEEN CONSTRUCTION DELAYS. THESE UPDATES ARE TO AID THE COMMUNICATION PROCESS AS WE ALL WORK TOGETHER TO COMPLETE THIS PROJECT IN A TIMELY MANNER  *

Utility and Street Construction is not easy. There will be dirt, mud, dust, equipment, and workers everywhere. Construction activity will be noisy, and getting to your residence will be difficult at times. We understand that it can be frustrating while it happens, but we ask for your patience and understanding as we make the much needed improvements to your street and utilities. Please do not hesitate to contact our Engineering Department with any questions or concerns. We can’t help if we don’t know.
