2025 Road Construction Updates – 4-25 Asphalt Paving Project Weeks of April 21 and April 28

Andrea Fencl
April 18, 2025

The Asphalt Contractor for the 4-25 Asphalt Paving Contract has some opening in their schedule next week. These projects should take less than 2 days each to complete.

Week of April 21

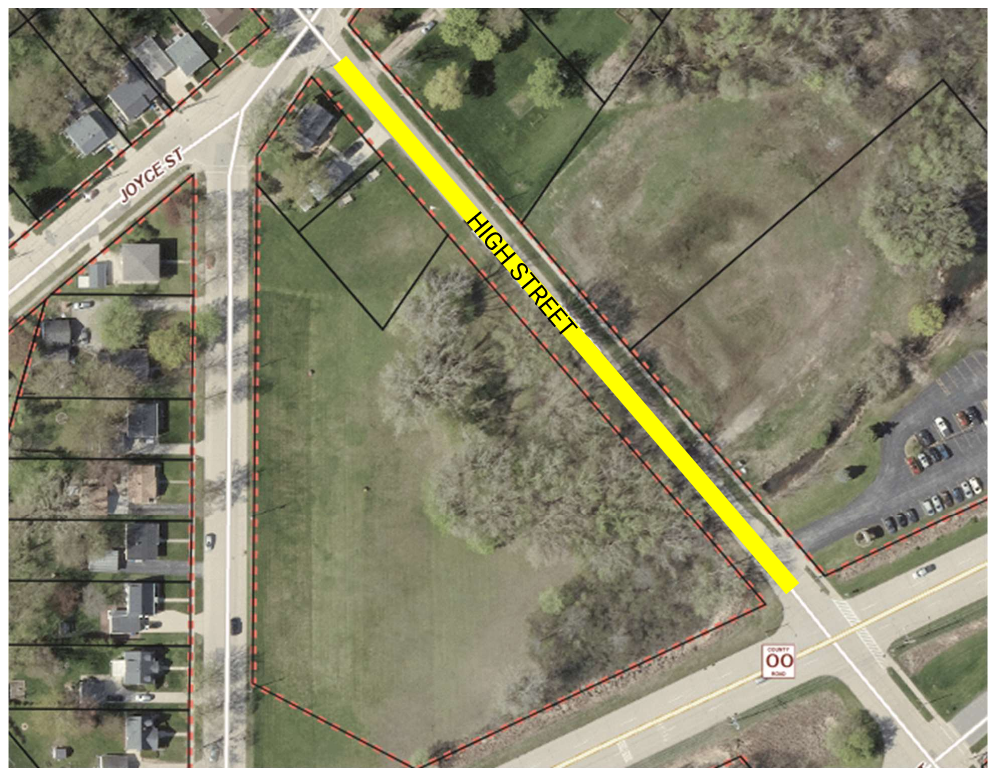

High Street (April 23-30) – Will be milling existing asphalt pavement and paving a 2” thick asphalt mat.

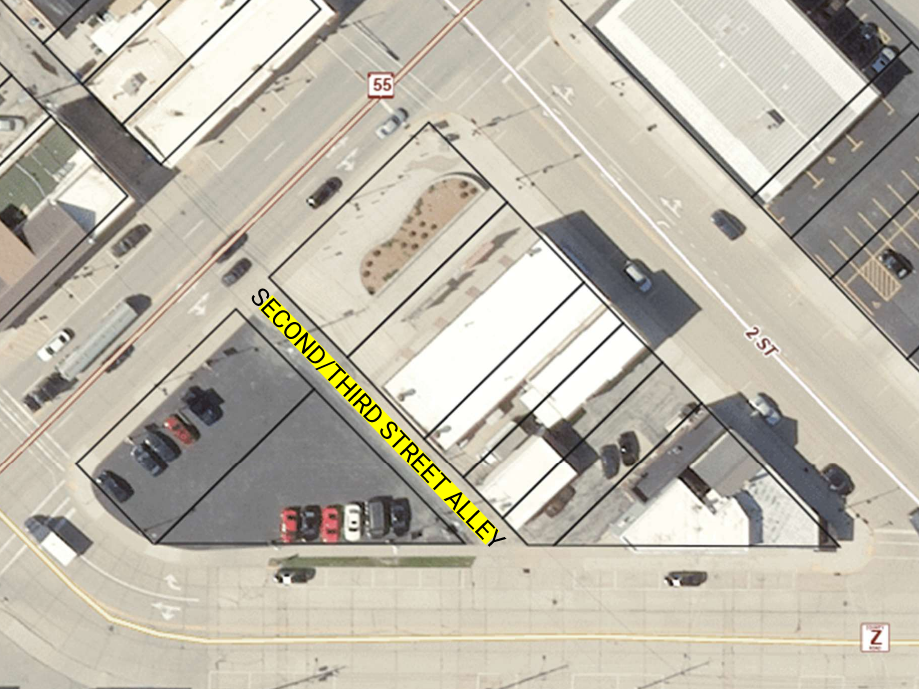

Second Street/Third Street Alley between Crooks Avenue and Dodge Street (April 23-30) – Will be milling existing asphalt pavement and paving a 2” thick asphalt mat.

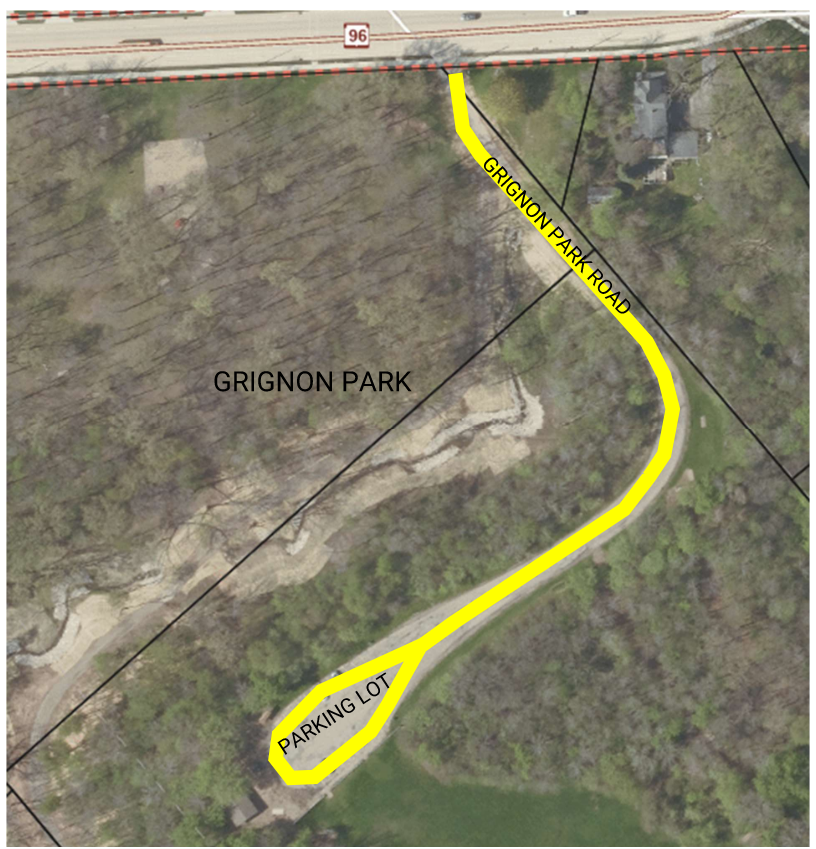

Upper Grignon Park entrance road and parking lot (April 23-30) – Will be milling the existing asphalt, grading millings & gravel, and paving a 3” thick asphalt mat.

Week of April 28

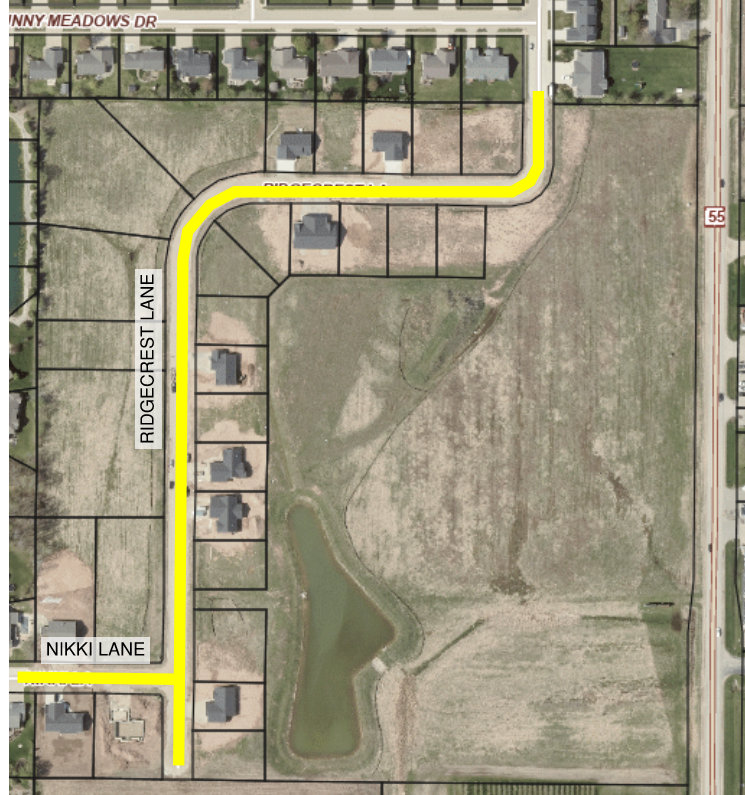

Ridgecrest Lane and Nikki Lane (April 28-May 2) – Pave a 24-foot wide 1” asphalt binder mat
